A NSW Government website

Waratah Super Battery Project

The Waratah Super Battery Project involves the construction of one of the world's largest battery energy storage systems. It will act as a shock absorber in the event of power surges from events like lightning strikes.

Key details

The Waratah Super Battery Project is more than just a battery. Its multiple parts work together to stablilise the grid and unlock renewables.

Besides the battery, it includes:

  • an overarching control system
  • arrangements for paired generation services
  • upgrades to the state’s existing transmission network.

The battery's capacity expected to be 850 megawatts (MW) / 1,680 megawatt-hours (MWh). It will have an active capacity of at least 700 MW and guaranteed usable storage capacity of at least 1,400 MWh.

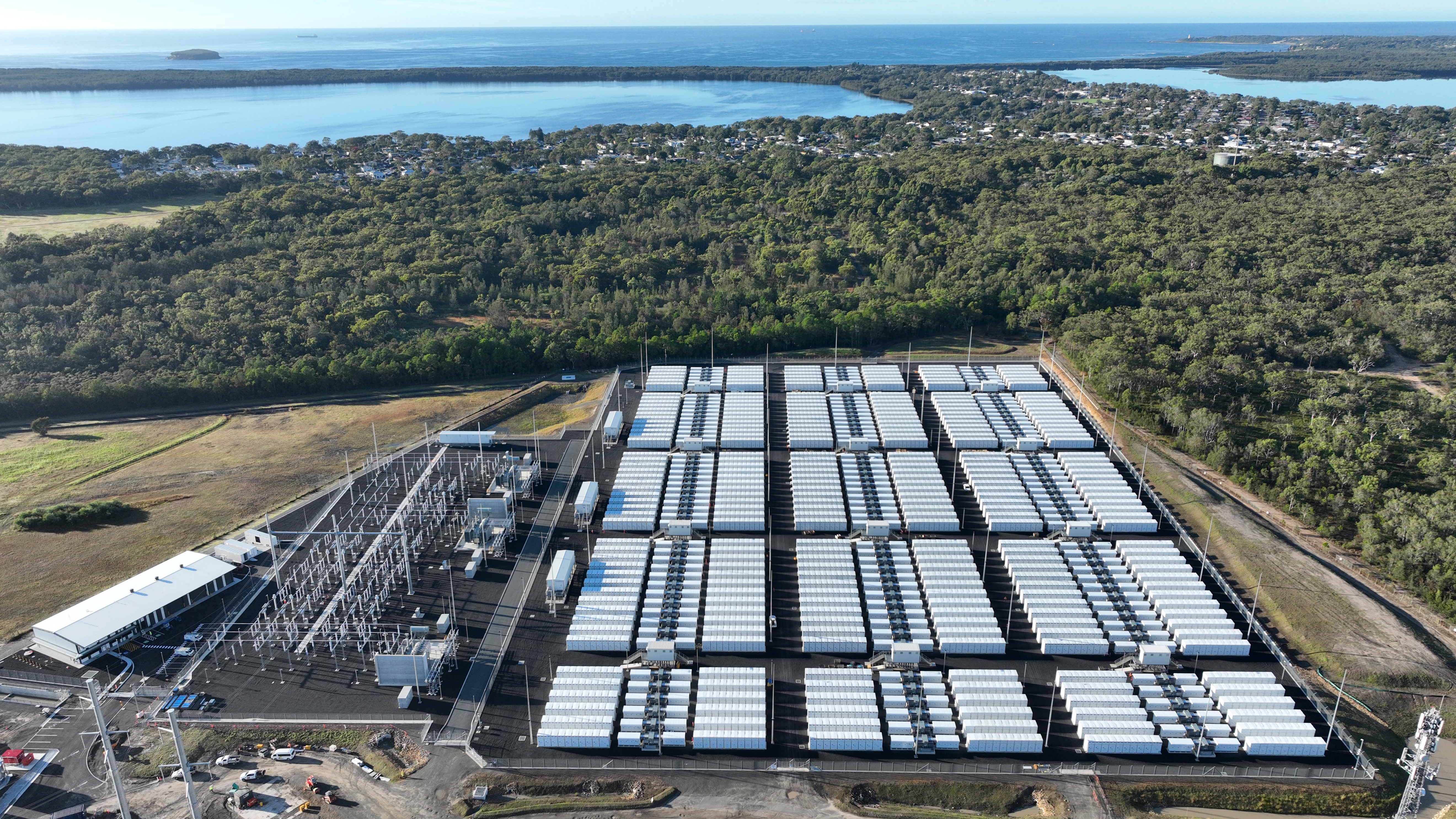

Waratah Super Battery - aerial photo

Planning

The NSW Government announced plans for the Waratah Super Battery Project in early 2022. It was declared critical State significant infrastructure and a priority transmission infrastructure project later that year.

The government granted planning approval in early 2023.

Construction

  • Akaysha Energy started construction for the battery component of the project at the site of the former Munmorah coal-fired power plant in May 2023 and finished in October 2024.
  • Transgrid have developed the overarching control system for the project and are implementing the network upgrades needed for its operation.
  • EnergyCo have appointed a portfolio of generators to provide paired generation services.

Operation

The project is currently undergoing testing and commissioning and will begin operation in 2025.

Why it's necessary

Three out of 4 of NSW's remaining coal-fired power plants will retire by 2035.

NSW's Electricity Infrastructure Roadmap is our path to replace these plants by upgrading our grid and powering the state with affordable, clean and reliable energy.

The Waratah Super Battery Project will help ensure that NSW consumers will continue to have reliable energy supply as coal plants retire.

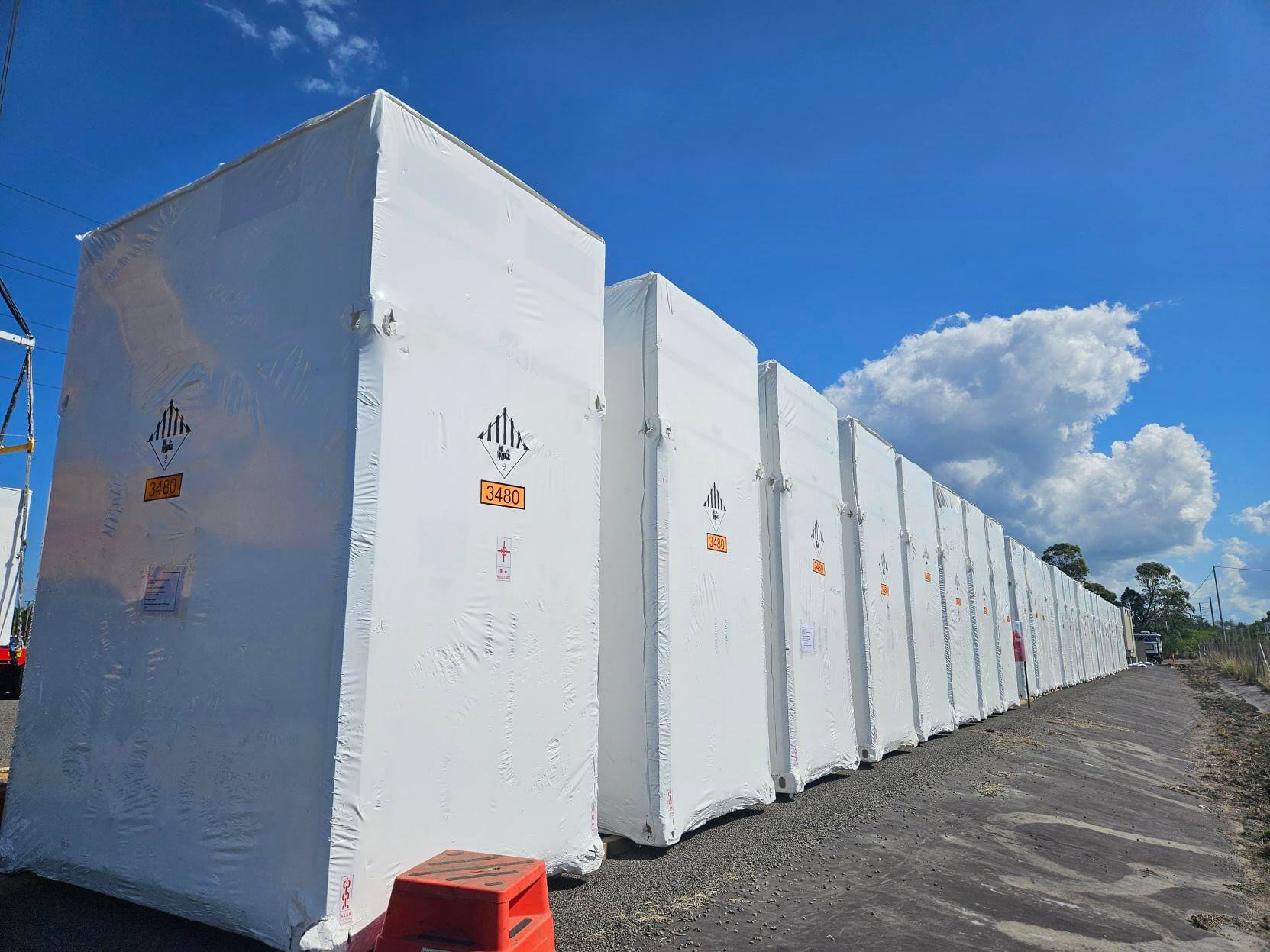

Battery units for the Waratah Super Battery

How it works

The Waratah Super Battery Project is made up of multiple parts. These parts work together so it can perform its unique role.

In addition to the battery energy storage system at the Munmorah site, it includes an overarching control system, arrangements for paired generation services, and upgrades to the state’s existing transmission network.

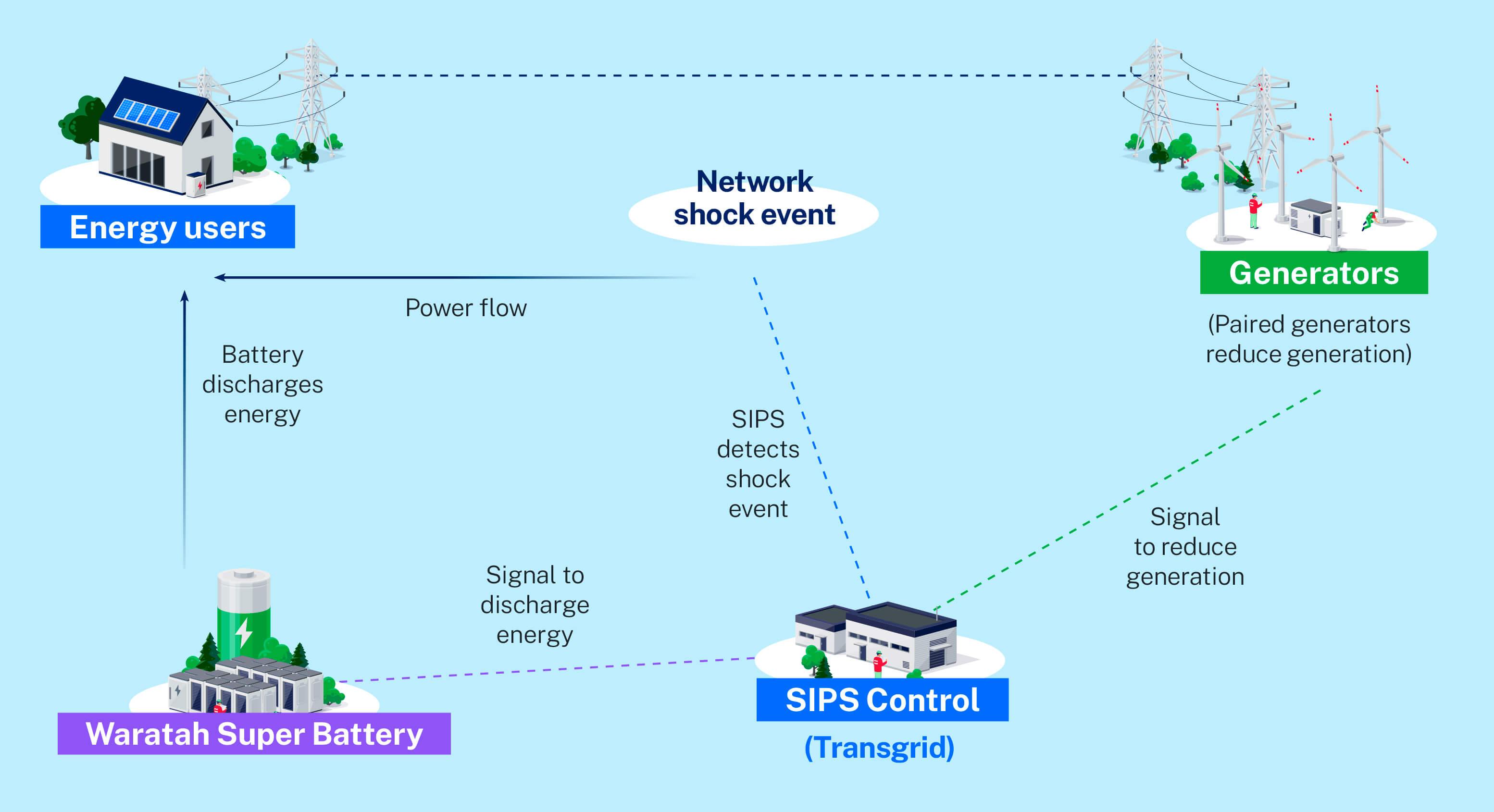

Together, these parts let it act as a ‘shock absorber’ for the energy system in the event of power surges and blackouts from events like lightning strikes.



Waratah Super Battery Project - how it works explainer (hi res)

Our role

As the infrastructure planner for the project, we were responsible for the early project development and for completing the contestable procurement processes for the project's battery component and paired generation services.

We also continue to oversee the project and work with our project partners to ensure its successful completion.

Our partners are:

  • Akaysha Energy, who are responsible for delivering and operating the battery when it is fully energised in 2025.
  • Transgrid, who are the network operator for the project, and responsible for coordinating and ensuring the delivery of the project as a whole.

Battery units for the Waratah Super Battery

Battery location

The NSW Government chose the site of the former Munmorah coal-fired power station for the battery component of the Waratah Super Battery Project.

This repurposes disused industrial land located close to existing power lines and substation, which helps minimise impacts on local communities and accelerates the roll-out of renewables in our state.

wsb-map-indicative-munmorah-site

View the Waratah Super Battery site and other projects on our interactive map

See where projects and works are taking place.

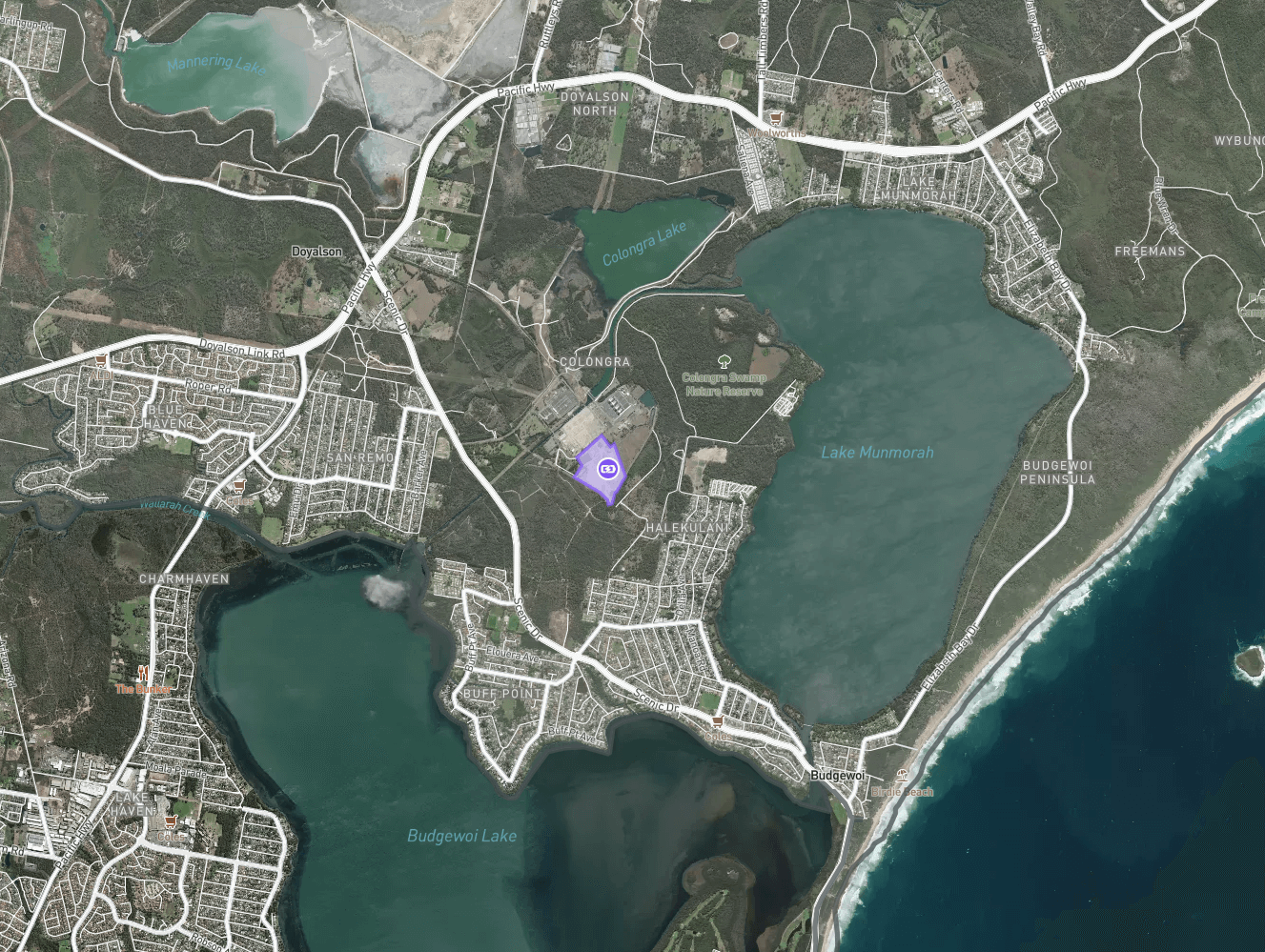

Waratah Super Battery site - Interactve map screenshot

Watch the video

Learn more about how the Waratah Super Battery Project will support NSW's grid.

More information

Priority transmission infrastructure project

The Waratah Super Battery Project is being delivered as a priority transmission infrastructure project under the Electricity Infrastructure Investment Act 2020 (the Act), and is the first such project to be delivered under this act.

Transgrid appointed as network operator

On 14 October 2022, the Minister for Energy appointed Transgrid as network operator and formally directed Transgrid to carry out the Waratah Super Battery Project under the act, published in the NSW Gazette here.

As network operator, Transgrid is coordinating the delivery of the project components described above and will be responsible for operating the SIPS once the project is operational.

Akaysha Energy appointed as SIPS Service Provider

In our role as infrastructure planner for the Waratah Super Battery Project, we appointed Akaysha Energy as the SIPS service provider following a competitive procurement process conducted throughout 2022.

Akaysha Energy are responsible for the construction of a battery energy storage system located at the former Munmorah coal-fired power station that can provide a guaranteed continuous active power capacity of at least 700 megawatts and a guaranteed useable energy storage capacity of at least 1400 megawatt-hours for the purposes of providing the SIPS service.

Portfolio of generators appointed to provide paired generation services

For the project to operate safely, the SIPS service must be paired with generators to create a “virtual transmission line”.

In the event of a network event, the SIPS control will issue a signal to discharge stored energy from the battery energy storage system into the network and simultaneously issue a signal for the paired generators to ramp down their power output, removing the potential for an overload on the transmission network, until the network event is resolved.

Munmorah Site

The Waratah Super Battery Project's battery energy storage system will be on the site of the former Munmorah Power Station site at 301 Scenic Drive, Colongra (the Munmorah Site).

On 2 September 2022, the Minister for Planning declared the potential development of the Waratah Super Battery Project on the Munmorah site as critical State significant infrastructure, in recognition of the critical nature of the project to NSW’s energy security.

For more information about the critical State significant infrastructure process, please refer to the NSW Government’s Department of Planning website.

We prepared a comprehensive environmental impact statement (EIS) which assessed the impacts of the Waratah Super Battery Project on the environment and surrounding communities. As part of the preparation of the EIS, we consulted with a range of stakeholders, including residents in the surrounding community.

The EIS was publicly exhibited between 11 November and 8 December 2022. Following the consultation period and after review of submissions, the NSW Government granted planning approval for the construction and operation of the project on 23 February 2023. A copy of the EIS determination is available on the Department of Planning Housing and Infrastructure’s (DPHI)  major projects website.

On 31 May 2023, Akaysha Energy began construction on the battery storage system at the Munmorah site. Construction for the project was completed in October 2024 and it is now undergoing testing and commissioning.

Revenue determination

The Waratah Super Battery Project is composed of two contestable components (a SIPS service and paired generation services) and a non-contestable component (network augmentations and SIPS control).

The Australian Energy Regulator (AER) in its role as regulator under the Electricity Infrastructure Investment Act 2020, is required to make revenue determinations for each component of the Waratah Super Battery Project.

Under the Act, the Scheme Financial Vehicle (SFV) must pay the network operator in accordance with the amounts set out in the AER’s revenue determination. The SFV recovers the cost of the NSW Electricity Infrastructure Roadmap from distribution network service providers who in turn recover those costs from NSW electricity consumers through network charges on their retail bills.

The AER has made and published the following revenue determinations.

  • On 14 December 2022, a revenue determination was made for the SIPS Service (contestable) component of the Waratah Super Battery project. On 16 June 2023, the AER made an annual adjustment to the SIPS service determination. The determination can be accessed here.
  • On 29 November 2023, a revenue determination was made for the contestable paired generation services component of the project. On 13 May 2024, the AER decided to review and remake the determination for the addition of a third paired generation provider. This determination can be accessed here.
  • On 15 December 2023, a revenue determination was made for the non-contestable network augmentations and SIPS control system of the project. On 19 June 2024, the AER decided to review and remake the determination to include an additional adjust mechanism to update the return on equity. The determination can be accessed here.

Other projects in the region

Hunter-Central Coast REZ transmission project Ausgrid

The Hunter-Central Coast Renewable Energy Zone will be the first renewable energy zone in Australia to upgrade existing distribution poles and wires.

Transmission tower Hunter

The Hunter Transmission Project is a critical project that will carrry electricity from inland renewable energy zones to homes and businesses around the state.

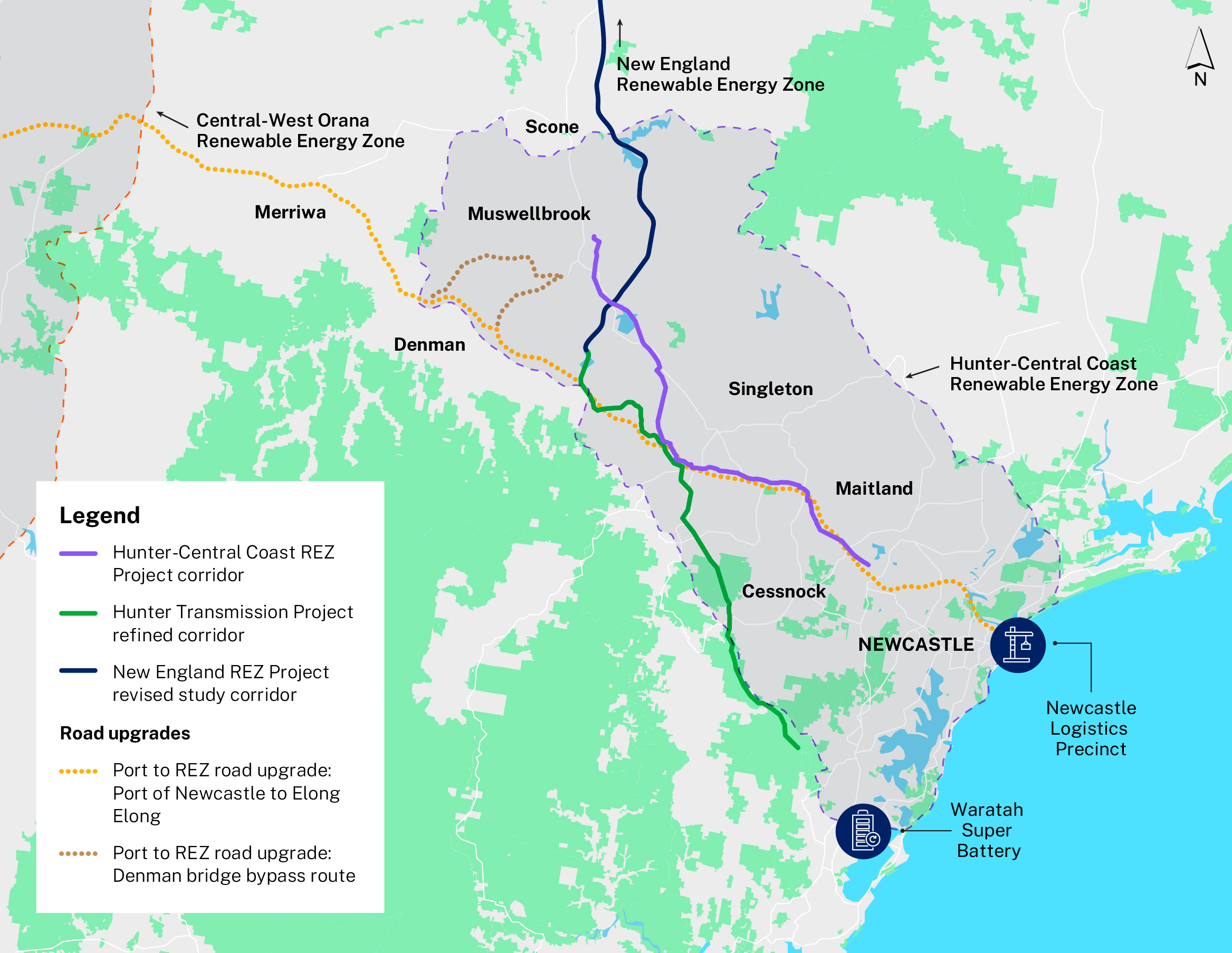

Hunter Central Coast region - Map of our projects

On 5 May 2025 we established the Hunter Central Coast regional reference group, which covers the Waratah Super Battery Project and other projects in the region.

Two land managers working

Learn about the projects that we are delivering to upgrade NSW's grid.

Contact details for the Waratah Super Battery Project

Akaysha Energy is responsible for building and operating the battery.

[email protected]

Transgrid is the network operator for the project, delivering a control system and the upgrades necessary to support its operation.

[email protected]

Get in touch with EnergyCo

Email us

Call 1800 849 794 (9 am to 5 pm, Monday to Friday).

Sign up for our Powering NSW e-newsletter.
